In this scenario, we are dealing with an existing tenant who already has location master data in Asset but is not using anything of Workplace.
When in doubt, go back to Space Management activation playbooks
Step |
Component |
Action |
Who |
|
|---|---|---|---|---|
1 |
PREPARATION |
These steps must be done in the days before the actual migration |
||
1a |
Asset |
Location hierarchy preparation This step may take considerable time. We recommend doing this in the days/hours before the actual migration. 1/ Before you can export the location master data from asset, verify that this hierarchy of “Location classes” is respected everywhere: Region >Site > Building > Floor > Space > Subspace 2/ Workplaces and Parking places are “Subspaces” that must be part of a Space (=Room). They cannot be directly under a Floor. 3/ Space Management does not support “Building sections” 4/ Pay attention to the Start Date of locations. The rule is that a child location cannot have a Start Date which is older than the Start Date of its parent. |
Manual |
Implementation consultant |
1b |
Asset |
Perform a quality check on the rules above |
Manual |
Implementation consultant |
1c |
Asset |
Export location master data from Asset to Excel In Asset there’s a set of purpose-built reports that allow exporting location data in XLSX files that are compatible with Space Mgt. 9 XLSX files must be exported:
These export files contain a special column “asset_unique_reference”. This will become the unique location_id in space mgt, Cobundu and Asset when the whole migration is completed. The first column “Id” must always be left blank. |
Manual |
Implementation consultant |
1d |
Excel |

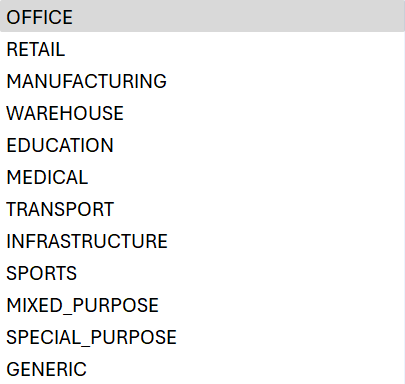

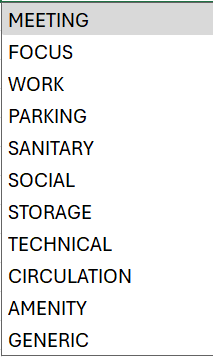

Do a quality check by opening the exported XLSX files. 1/ For the “Types” files: there must be a column with class values.
2/ Start Date of locations can be left blank except for root-level locations (these could be regions or buildings). 3/ Pay attention to Time Zones! |
Manual |
Implementation consultant |
2 |
REQUEST |
Plan ahead so that all involved teams can organize |
||
2a |
Zendesk |

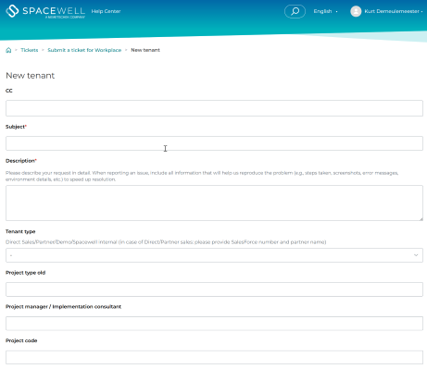

B2 - Request new Workplace tenant https://support.spacewell.com/hc/en-001/requests/new?ticket_form_id=26226428287132 This procedure will deploy Workplace including space management. Note that “Tenant identifier” is important – this is the official technical name of the tenant (from Asset). |
Manual |
Implementation consultant |
2b |
Zendesk |
Send notification of the request to product team and create Jira item in the QUEEN project + specify “Cobundu Core” as team |
Manual |
Support team |
2c |
Teams |
Share Jira item and details in team channel Space Management activation + agree on a date for activation |
Manual |
Implementation consultant |
2d |
Communication |
Send notification to all end users. On the agreed date for activation, there will be some downtime and impact on various touchpoints! |
Manual |
Implementation consultant and/or support team |
3 |
DEPLOYMENT |
These steps must be done in the days between the request and the actual migration |
||
3a |
Cobundu |
Deploy new tenant |
Automation |
Cobundu Core team |
3b |
Space Mgt + storage app |
Enable space management for tenant (db schema + roles) via script |
Automation |
Cobundu Core team |
3d |
Integration platform |
Deploy new tenant |
Manual |
Integration team |
3e |
Studio |
For the specific tenant, create or edit an account with role “space.admin” who will perform the data import. |
Manual |
Implementation consultant |
4 |
ACTIVATION |
These steps must be done in the days between the request and the actual migration |
||
4a |
Asset |
Activate the “Space management integration” module in Asset Global assistance page: https://onespacewell.atlassian.net/wiki/spaces/KB/pages/4834983937/Space+Management+integration Activation instructions: |
Manual |
Implementation consultant |
4b |
Integration platform |
Login to https://integration.spacewell.com/ Space Sync – Setup connectors to Asset and to Space Management Instructions: https://onespacewell.atlassian.net/wiki/spaces/KB/pages/4834983937/Space+Management+integration |
Manual |
Implementation consultant |
4c |
Integration platform |
Activate Space Sync for the tenant |
Manual |
Implementation consultant |
5 |
DATA MIGRATION |
These steps should be executed outside business hours |
|
|
5a |
Teams |
There is a Teams channel for “Space Management activation”: Notify Cobundu core, Mobile, Axxerion core teams when the actual migration will take + coordinate the next steps It’s important that the next steps are executed in close collaboration between implementation consultant and dev teams.
|
Implementation consultant |
|
5b |
Asset |
Location hierarchy preparation This repeats the preparation steps! Ensure that the location hierarchy is prepared for use in Space Management, else the subsequent steps will fail. |
Implementation consultant |
|
5c |
Cobundu |
Run pre-processing script (The script will flush locations in Cobundu because they still use old-style numerical location ids from Asset at this point. The script will perform data cleanup tasks: Updating old location_ids (from Asset) in settings, timeslots, kiosks etc) |
Cobundu Core team |
|
5d |
Space Management |

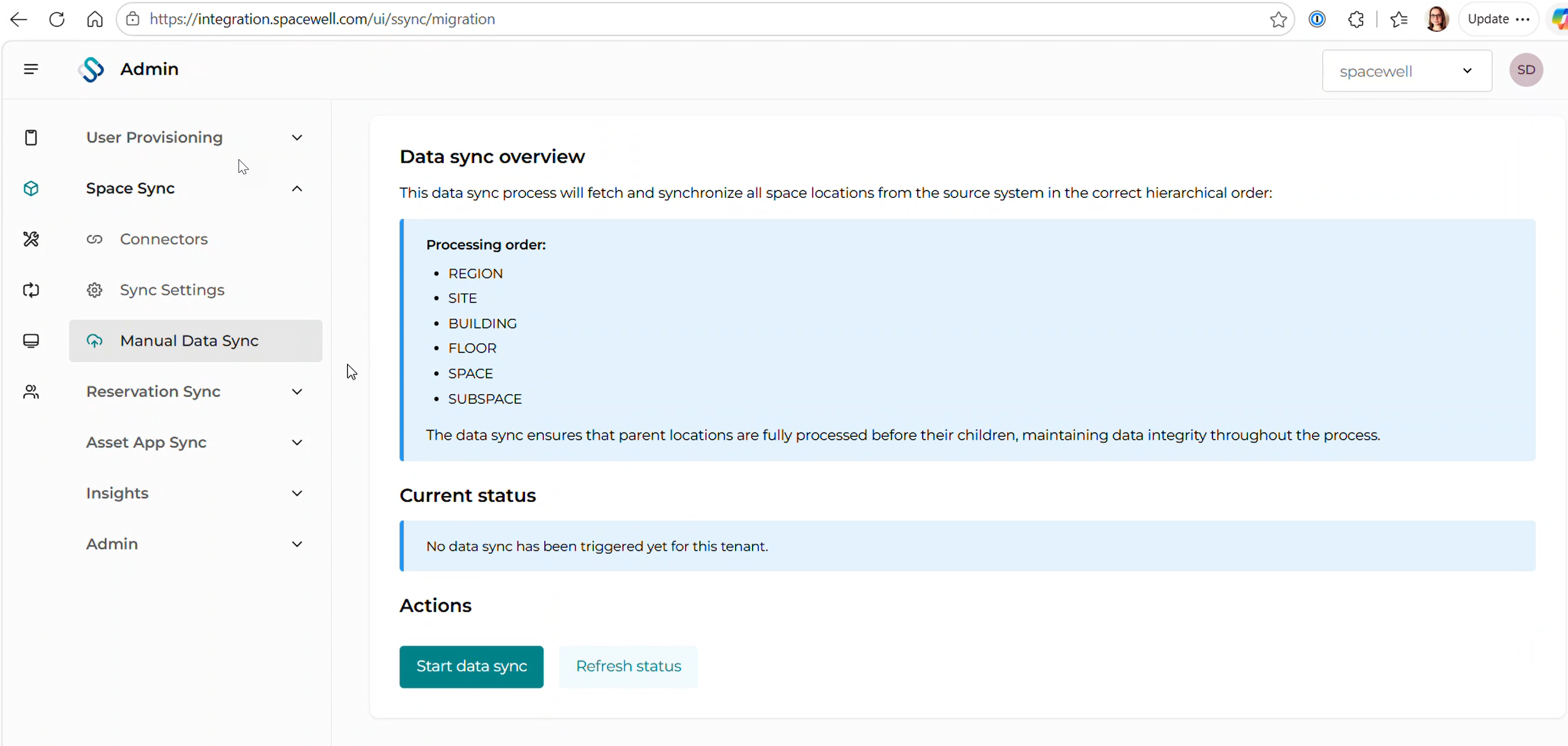

Import location master data in Space Management. Execution sequence:
|
Implementation consultant |
|
5e |
Back-end |
Run post-processing tasks
|
Cobundu Core team + mobile team |
|
5f |
Integration platform |
Execute a manual data sync from Space To Asset: |
Integration team |
|
5g |
DWH |
|
BI team |
|
6 |
Quality assurance |
Checking all integrations |
|
|
6a |
Space Mgt |
Check if locations are all available in Space Explorer |
Implementation consultant |
|
6b |
Studio |
Check if locations are visible |
Implementation consultant |
|
6c |
Asset |
Check if locations are under control of space management. |
Implementation consultant |
|
6d |
Impact |
Check normal behaviour of various touchpoints (if in use):
|
Implementation consultant |
|
6e |
Communication |
|||
7 |
Floor plans |
|
|
|
|
There’s currently no automation in place for floor plans from MCS, from Axxerion (if any) or from Studio to Space Management |
|||
7a |
Prepare drawings |
See guidelines: |
Customer |
|
7b |
Space Management |
Import floor plans Use the normal procedures in Space Management:
|
Implementation consultant or customer |
|
7c |
Floor plans in Studio |
Configure Space Mgt layouts in Studio |
Implementation consultant or customer |
|
